Bunker Hill Provides Mine Restart Project Update

Back to all news

TORONTO, March 22, 2022 – Bunker Hill Mining Corp. (the “Company”) (CSE: BNKR, OTCQB: BHLL) is pleased to provide an update on its Bunker Hill Mine project, following on from its previous update in November 2021.

Sam Ash, CEO stated: “I am very pleased with the progress that the Bunker Hill team and its partners are making in finalizing the restart plan for the mine, concurrent with our on-going equity financing. We remain on track to enable a construction decision in Q2 2022.”

RESTART PROJECT UPDATE

The Company continues to advance technical studies to a level that will enable a construction decision to be made and a Pre-Feasibility Study (“PFS”) to be published during Q2 2022. The PFS will focus upon mining of Measured and Indicated Resources that maximize cash flow and returns on initial capital invested, leveraging existing infrastructure and the Pend Oreille process plant once it has been relocated to the Bunker Hill site. The Company aims to have the mine in commercial production by the end of 2023, in accordance with the summary timetable shown below.

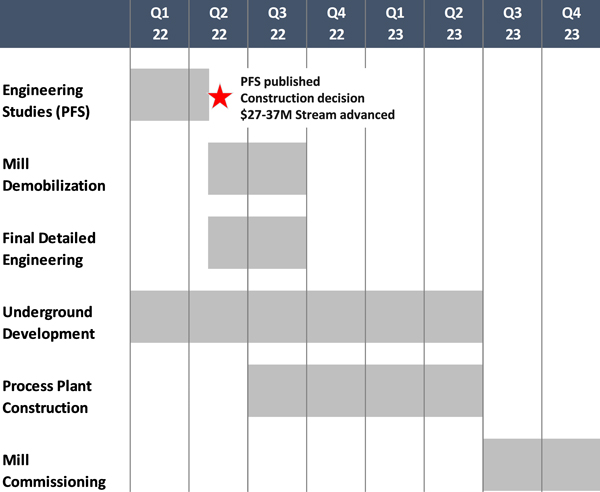

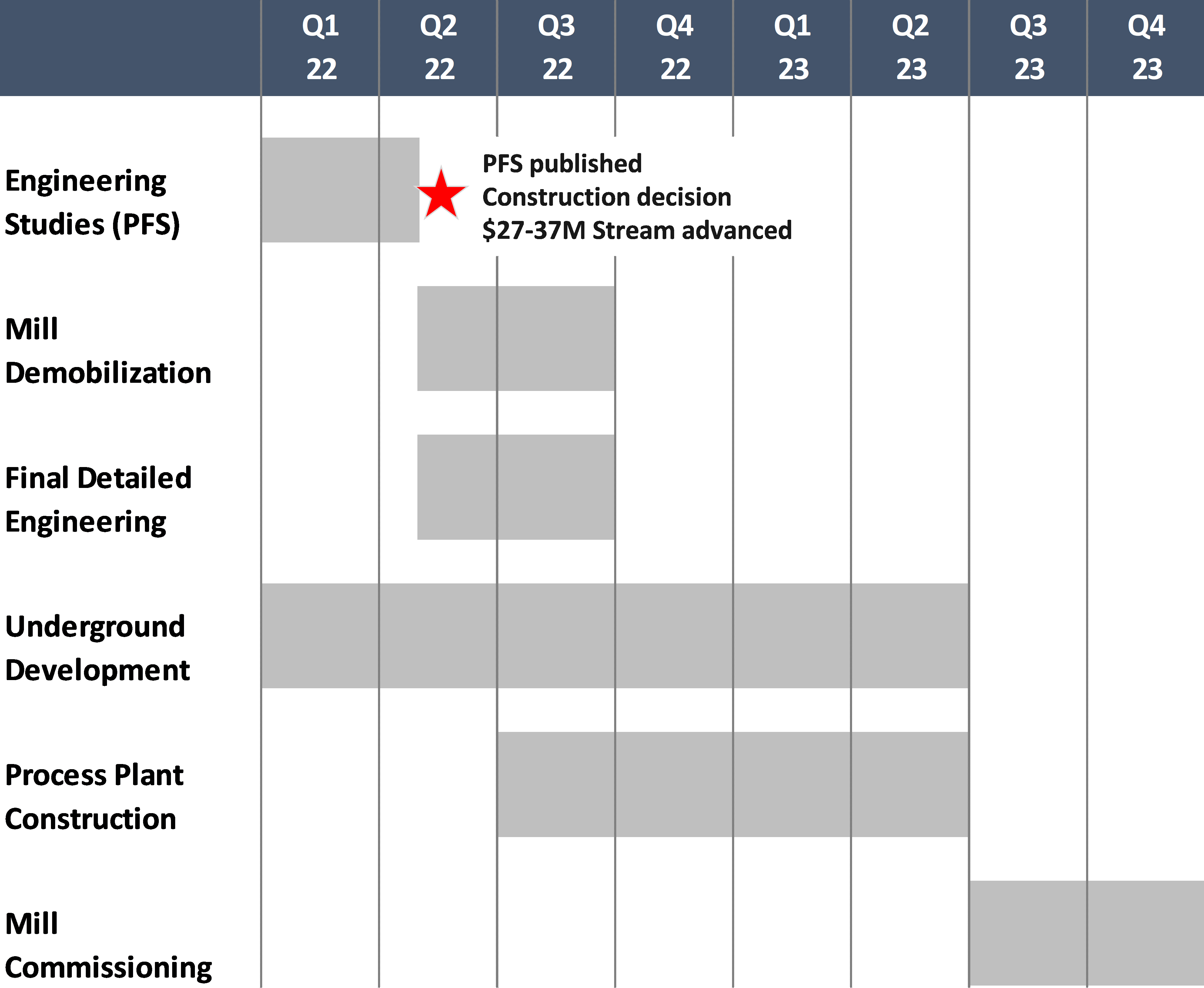

Figure 1: Bunker Hill Planned Development Timeline

The technical studies to support both a PFS and a Construction Decision remain on track, with updates to some of the key and supporting activities detailed below:

Figure 2: Technical Studies Update

Project Work Currently In-Progress Completion %
(To PFS)
Process Plant Engineering
  • GA drawings for processing plant and crushing gallery complete. Multiple simulation exercises have indicated reduced initial construction capital expenditures from PEA estimates.
  • Trade-off studies complete. These affirm preference for an underground location for the primary crushing circuit on Level 9, with milling and flotation circuits on surface within existing building.
  • Final cost analysis, detailed construction planning and construction contractor negotiations on-going.
80
Tailings and Backfill Plant Engineering
  • Final paste plant design and location trade-offs on-going.
  • Opex trade-off analysis and mine scheduling on-going.
  • Geotechnical analysis of back-fill requirements indicates significant cost savings from PEA estimates.
85
Metallurgy
  • Metallurgical studies continue to further optimize the mill and process flow sheet used in the PEA.
  • Final Lock-Cycle Testing (LCT) on-going.
80
Geotechnical Study
  • Golder and Associates study complete, supporting geotechnical assumptions made within the PEA.
100
Mine Planning
  • Detailed stope sequencing and optimization on-going.
  • Ore haulage trade-off studies complete. Crushed ore to be moved from UG crushing gallery to surface processing circuits via conveyor within the Kellogg Tunnel.
85
Pend Oreille Plant Demobilization
  • Project/process plant manager appointed.
  • Final demobilization planning on-going, set to meet timelines agreed with Teck, with cost estimates in line with PEA.
85
Current Mining and Rehabilitation Activities
  • CMC (mining contractor) building organic capacity on site. This includes adding local staff and acquiring mining equipment including LHDs.
  • Rehabilitation of UTZ drift on 5-Level completed on schedule.
  • Initiating construction of decline ramp to connect 5-Level with existing 6-level spiral ramp for rubber-tired equipment.
N/A
Bunker Hill Surface Upgrades
  • Mine yard and surface facilities now cleared to accept Pend Oreille plant equipment.
  • Finalizing plans to upgrade electrical infrastructure to both Kellogg and Wardner Portal yards.
N/A
